Capital Projects
Pembina Trails School Division is consistently working to provide learners with safe and inclusive learning spaces by maintaining our schools and adding new spaces to match the growing needs in our division.
Projects marked with an asterisk (*) are in partnership with the Province of Manitoba.
Projected completion: 2027-2028
The project to build a new dual-track French and English kindergarten to Grade 8 school in the Prairie Pointe neighbourhood is well underway. The school will have capacity for 800 students and 134 child-care spaces, and will include classroom spaces, a gymnasium, a multipurpose room, and specialized learning areas to support hands-on programming. It will also include resource, guidance and student support spaces, human ecology, life skills and a hygiene room, library learning commons, a kitchenette, applied technology spaces, and associated administrative, ancillary, and building support areas.

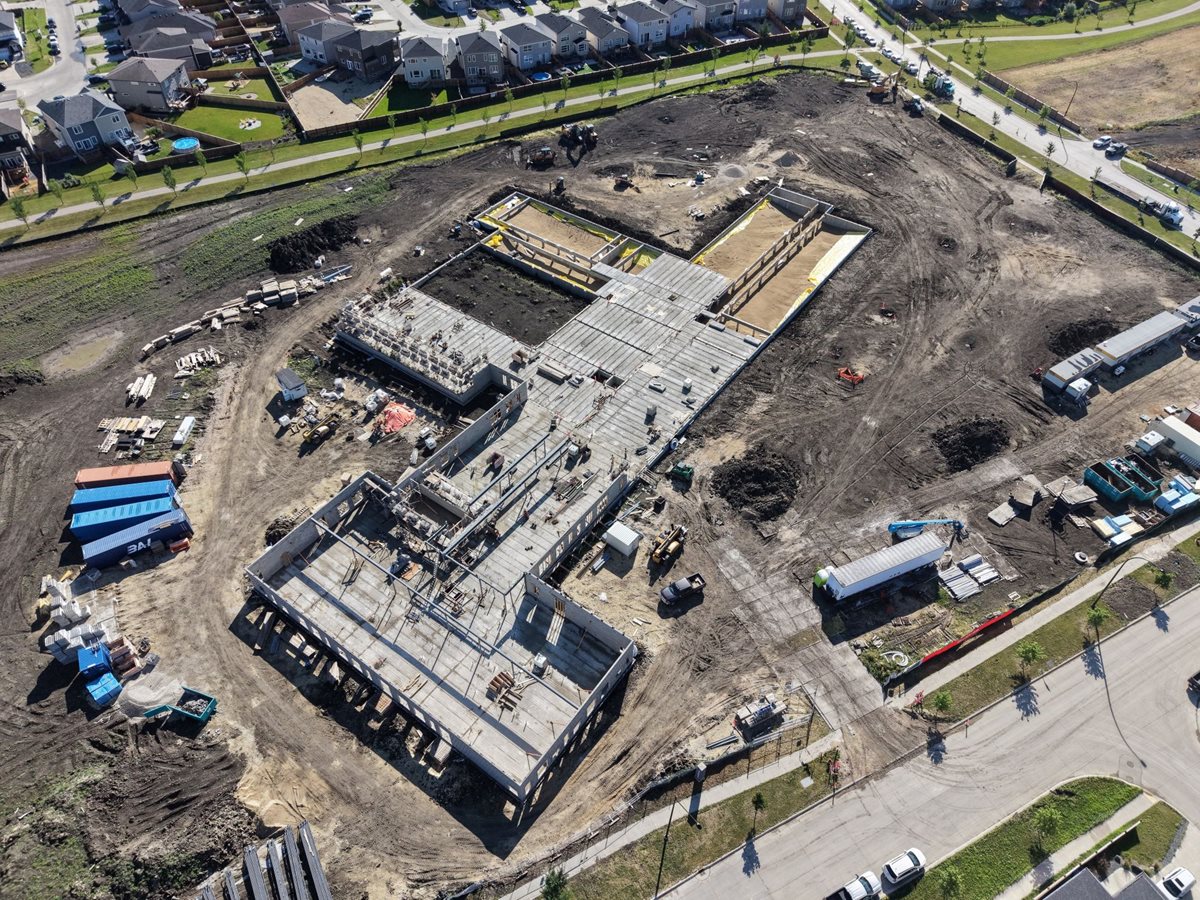

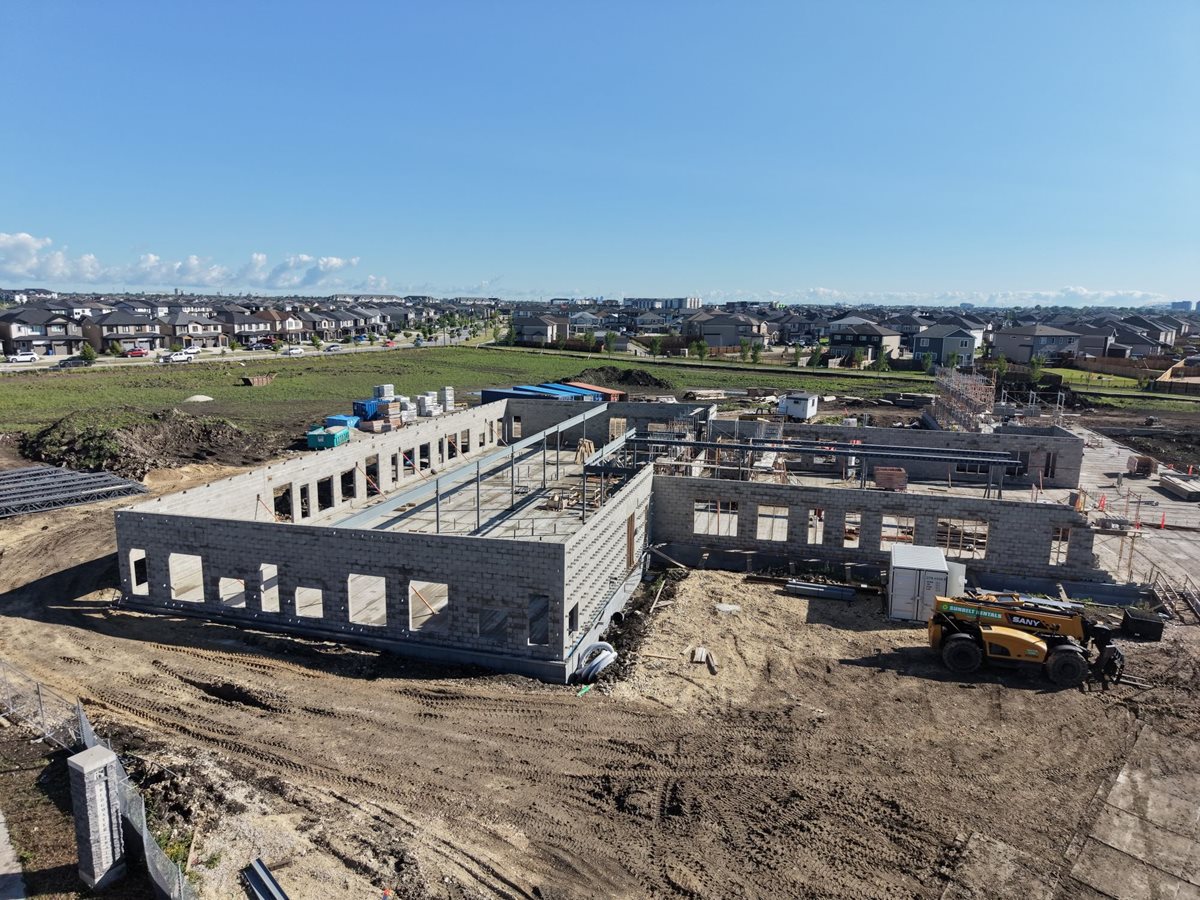

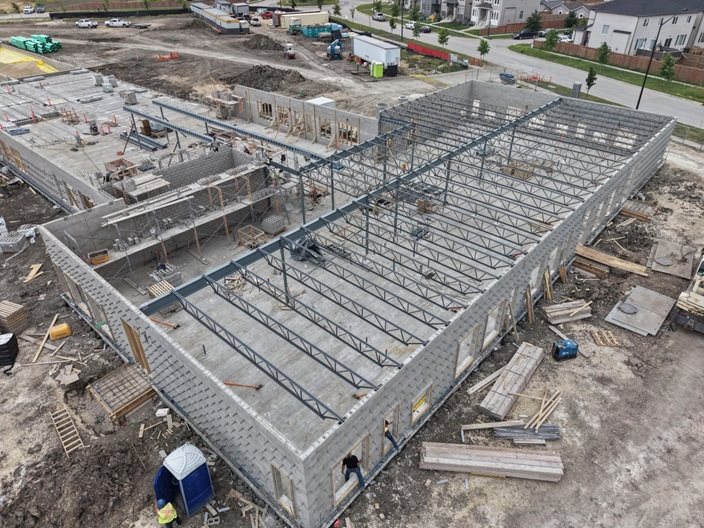

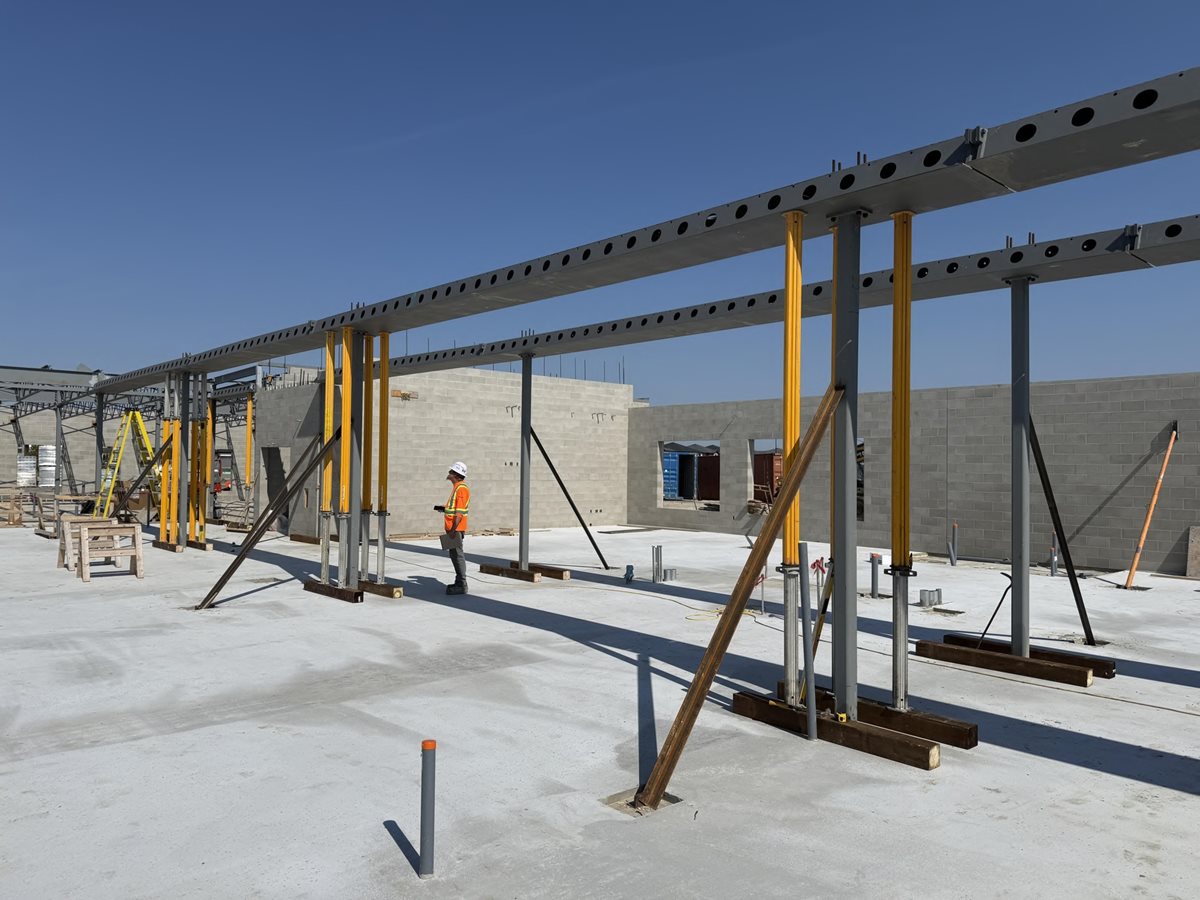

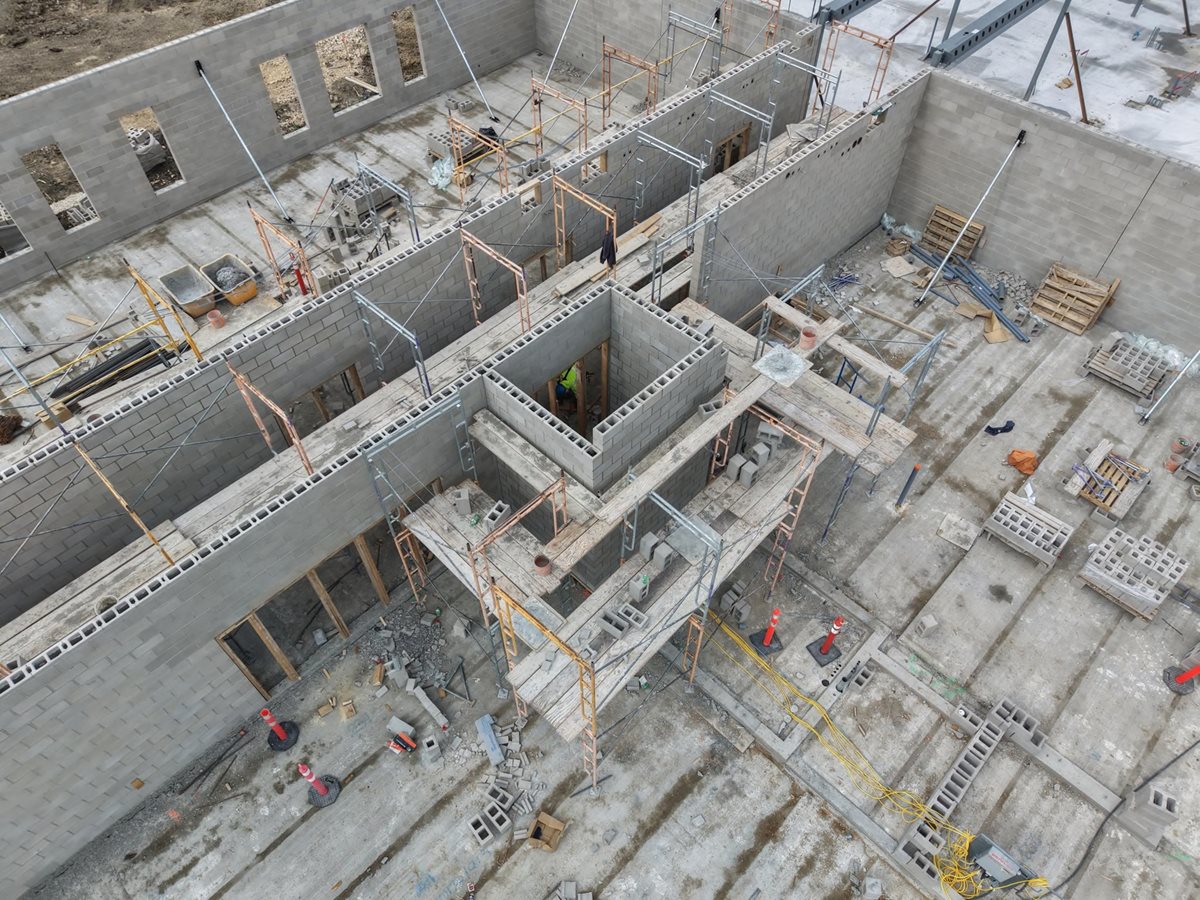

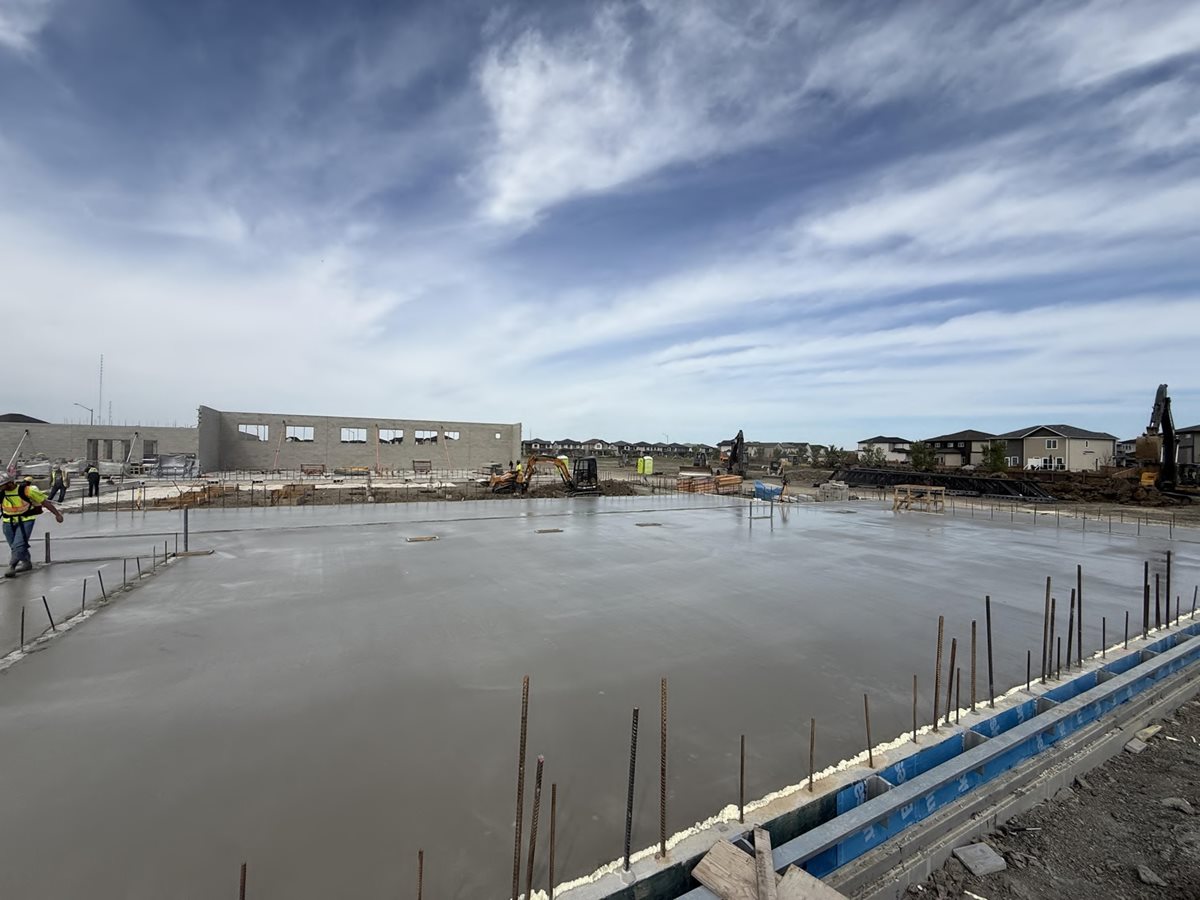

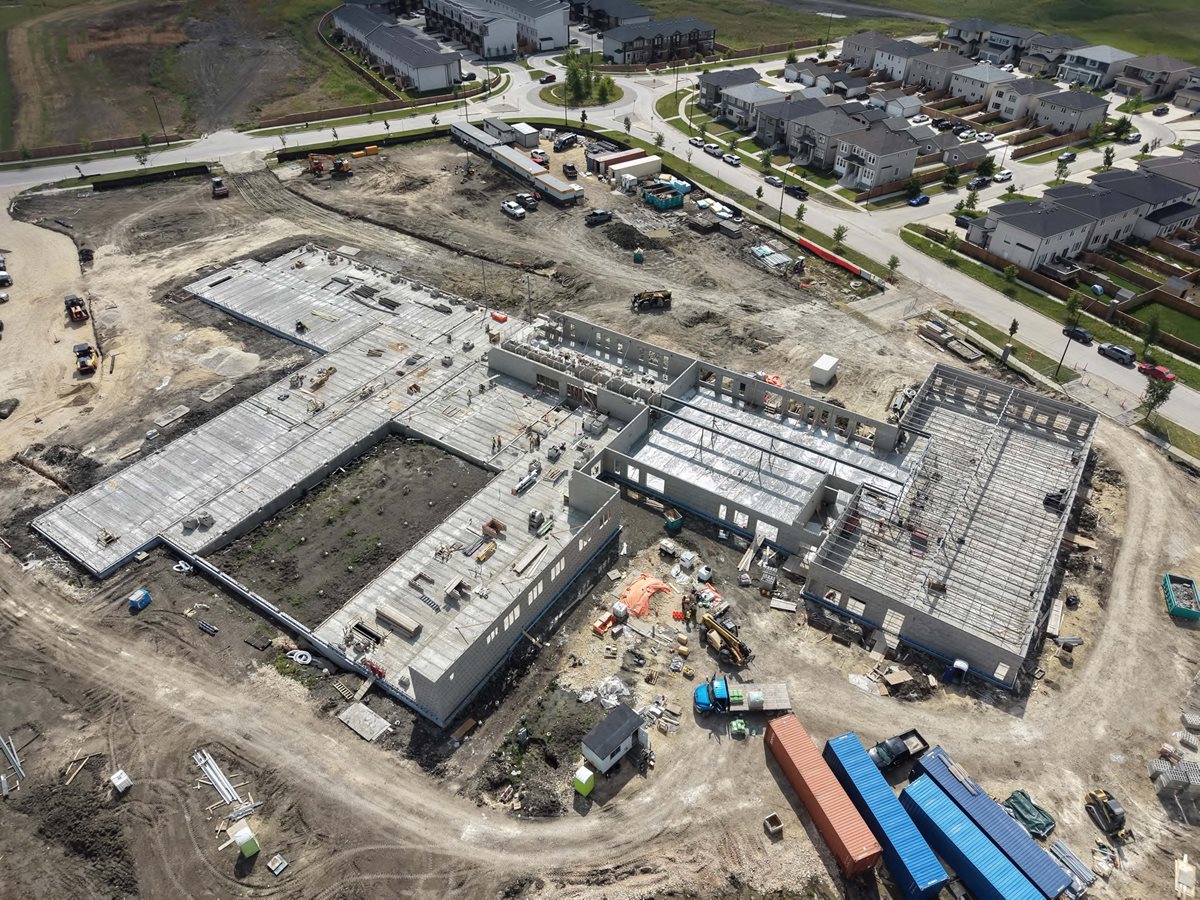

Structural steel is being installed, including second-storey framing and preparation for future roof installation activities. Mechanical and electrical rough-ins have advanced throughout the building, including daycare, crawlspace, and classroom areas. Interior steel stud framing is progressing within classroom, corridor, daycare, and administrative spaces. Masonry activities have continued as well, including blockwork preparation. Site servicing and civil works advanced as well with bus loop construction, sidewalk preparation, and exterior grade beam activities.
![]() | ![]() |
![]() | ![]() |
The following are renderings of what the exterior of what École kā-iskonākwahk School will look like upon completion:
![]() | ![]() |
Projected completion: Fall 2026

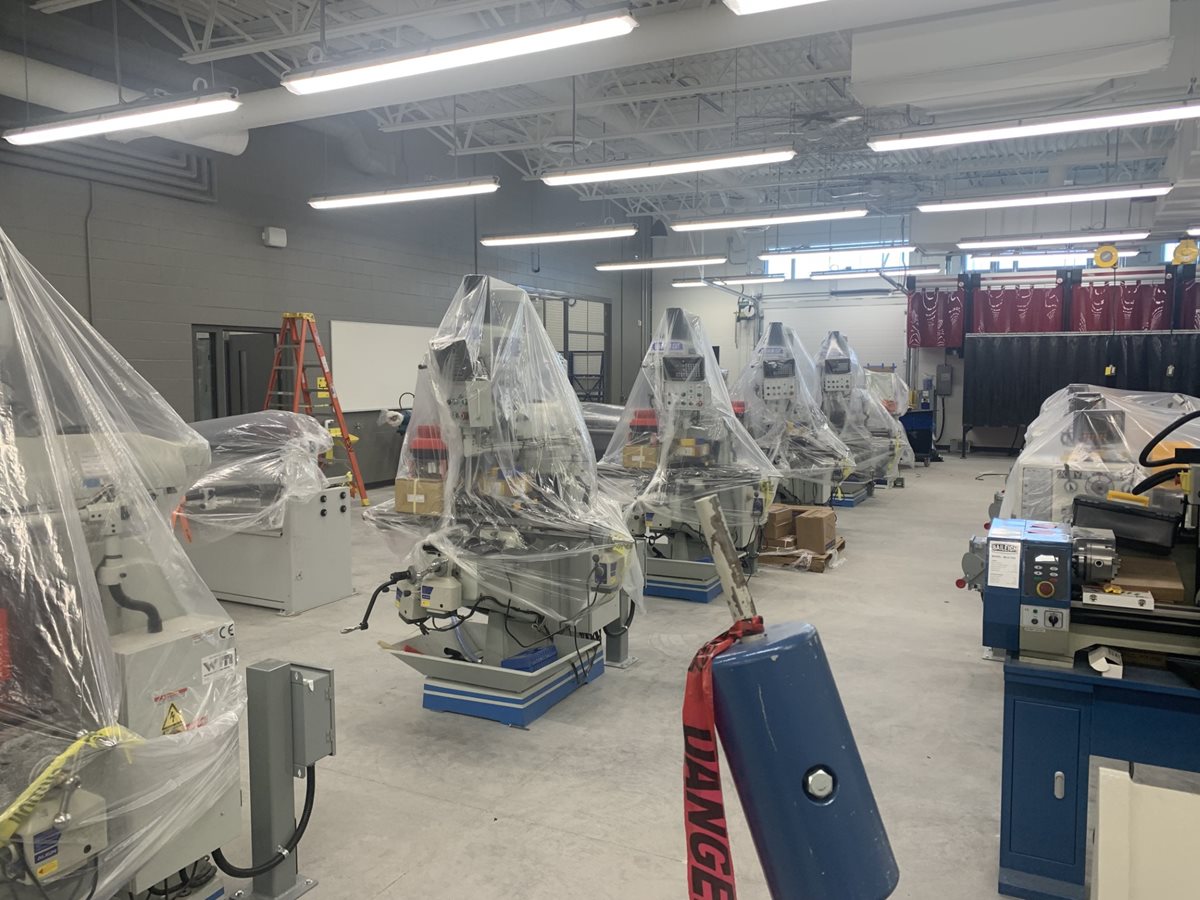

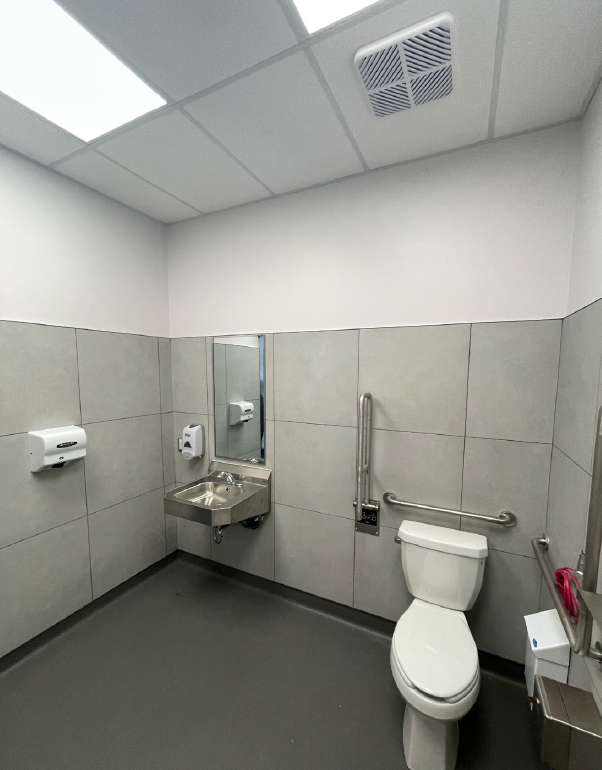

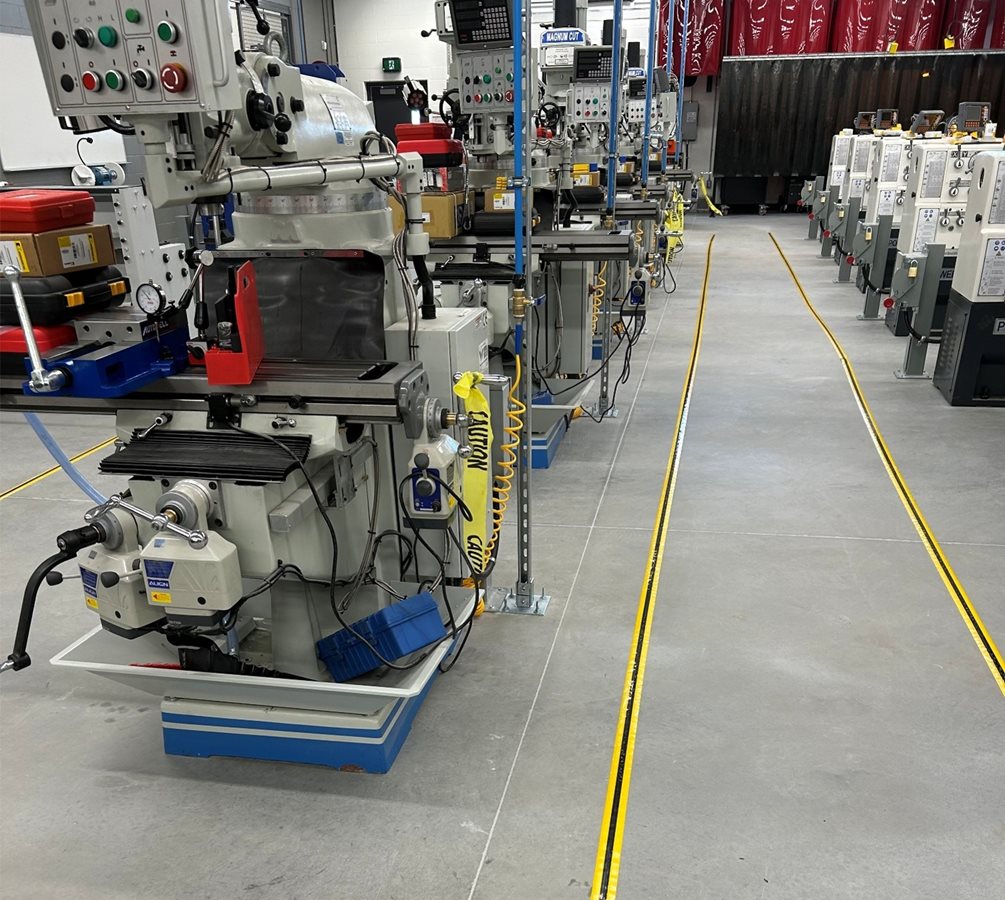

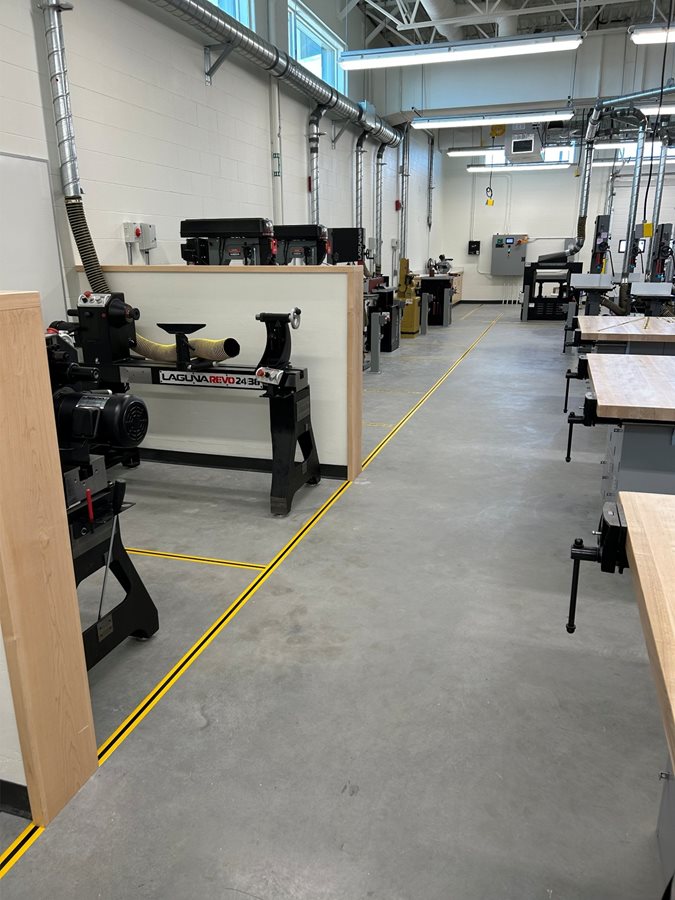

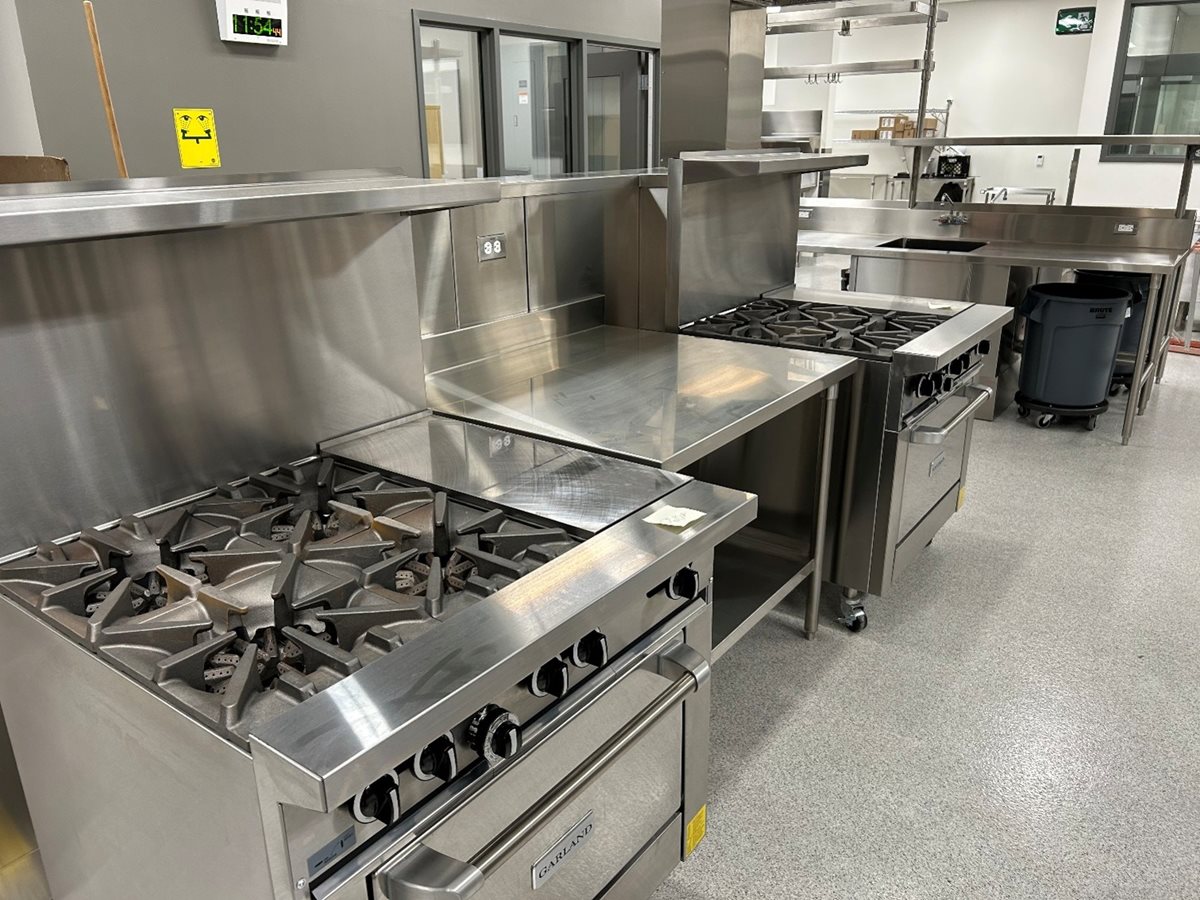

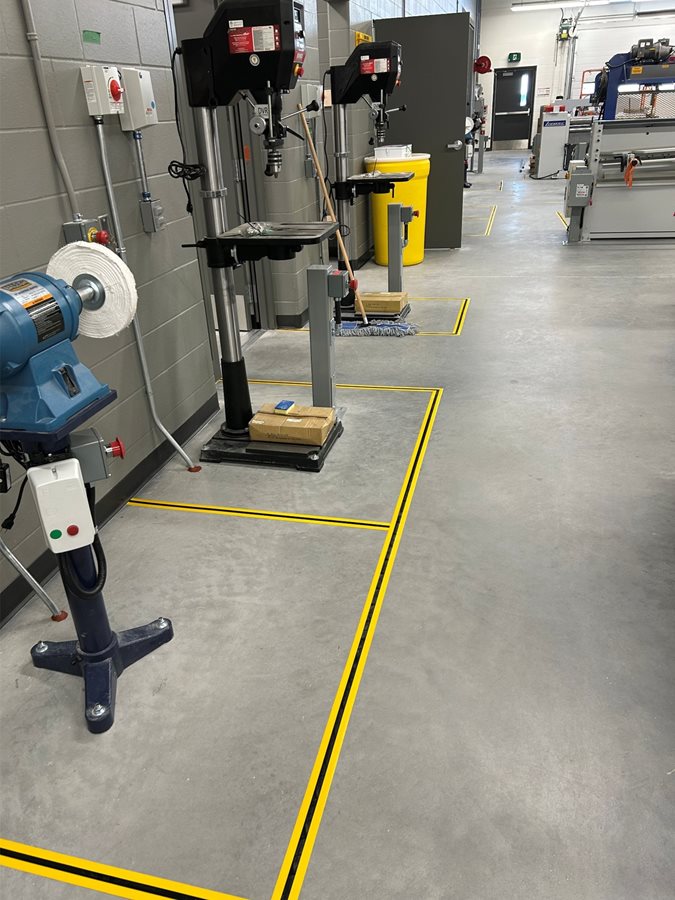

The addition to Pembina Trails Collegiate that will house technical vocational programs is nearing completion. The new space will provide opportunity for up to 120 students to access machining, welding, culinary arts, and pastry arts programming, as well as hundreds of other students to complete high school credits in technology education, including human ecology and industrial arts programs.
![]() | ![]() |
![]() | ![]() |
Projected completion: Modular classrooms 1 and 2 complete, Modular classroom three starting construction in October 2026
Three modular classrooms are being added at École Viscount Alexander to provide additional learning space for students.

Projected start: October 2026

The replacement of another roofing section at Prairie Sunrise School is set to begin. The roofing consultant is Agassiz Consulting Group, and the work has been awarded to Master Roofing Ltd.
